Zoning vs. Building Codes: What Home Builders Need to Know

Zoning vs. Building Codes: What Home Builders Need to Know

Building Basics
To build successfully, you must satisfy two distinct sets of rules. It is vital to understand the difference between "Where you can build" and "How you must build." This is the fundamental distinction between the zoning code, which governs land use, and the building code, which governs construction standards.
Published 22 Dec 2025

Before diving into the specifics, it is critical to distinguish which authority controls what part of your project. A zoning permit authorizes the use of the property, while a building permit authorizes the construction techniques.

Feature Zoning Ordinances Building Codes
Primary Focus Land use, placement, and density Safety, structure, and habitability
Key Question “Can I build a house here?” “Is this house built safely?”
Governing Body Planning Department / Zoning Board Building Department / Fire Marshal
Common Constraints Setbacks, height limits, lot coverage Framing, electrical, plumbing, egress

1. Zoning Ordinances (The “Where” & “What”)

Zoning dictates how a piece of land can be used. It acts as the primary legal mechanism for deciding how land is used within a municipality. It is intended to separate incompatible land uses (like putting a noisy factory next to a quiet library).

Comprehensive Planning: Local governments often implement a long-term strategy that dictates how they want land to be used for the betterment of their population. This is known as a comprehensive plan. Your specific project is evaluated against this broader vision to ensure it aligns with the community’s growth goals.

  • Land Use: Classifications include Residential, Commercial, Agricultural, and Industrial. These classifications are defined visually on a specific zoning map adopted by the city.
  • Density: This determines how many structures can be on a lot (e.g., Single-family vs. Multi-family).
  • Permitted Use (By-right): You are allowed to build as long as you follow the rules.
  • Conditional Use: You might be allowed to build, but you need special permission (often relevant for Accessory Dwelling Units or ADUs).
  • Architectural Standards: Some zones enforce aesthetic rules, requiring new structures to adhere to specific materials or styles matching the neighborhood’s look.

2. Building Codes (The “How”)

Building codes focus entirely on safety and habitability. Consequently, how you intend to use the structure dictates the specific safety rules you must follow. They ensure the house won’t collapse, catch fire easily, or harm the occupants.

  • Reference Standards: Most U.S. municipalities use the IRC (International Residential Code) for one- and two-family dwellings. For larger or commercial projects, widely adopted codes include:
  • Operational Safety: Experienced builders note that building codes can dictate safety standards for specific operational equipment, such as commercial kitchen appliances, not just the building’s infrastructure. This ensures that even the tools used inside the building meet safety criteria.
  • Safety Areas: Fire safety, structural integrity, electrical, and plumbing.
  • Critical for Small Homes: Codes dictate minimum room dimensions, hallway widths, and ceiling heights. If your small house plan has a sleeping loft with a 4-foot ceiling, it may fail building code inspection. The 2021 IRC generally requires a minimum ceiling height of 7 feet for habitable rooms, with specific exceptions for sloped ceilings that must be carefully calculated. Decoding blueprint symbols on your plans helps you verify these dimensions before submitting for permit review.

Key Takeaway: You can have a house that meets all safety codes (Building Code compliant) but is illegal to build on your specific lot (Zoning violation). You need both.


Anatomy of a Building Lot: Understanding Constraints

When looking at a plot of land, you need to visualize the invisible lines that shrink your buildable area. Navigating these constraints requires understanding specific industry vocab terms that appear on surveys and plats. Just because you own the land doesn’t mean you can build on every square inch of it.

Setbacks And Easements
Understanding constraints: setbacks and easements explained

Setbacks

Definition: The mandatory distance a building must be from the property lines (Front, Side, and Rear). Setbacks are essentially about keeping distance from neighbors to ensure privacy and fire safety.

The Impact:

On a large rural plot, setbacks are rarely an issue. On a narrow urban infill lot, they are critical.

  • Example: If a lot is 40 feet wide, but the zoning requires 10-foot side setbacks on both sides, your maximum house width is only 20 feet. Common failure modes in permitting occur when builders miscalculate these setbacks by as little as 6 inches.

Easements

Definition: Legal rights for specific third parties to access or use parts of your land.

  • Utility Easements: Power lines, sewer pipes, or gas lines running under or over your property.
  • Access Easements: A driveway crossing your land so a neighbor can reach their property.

Warning: You generally cannot build permanent structures over easements. If a sewer line runs through the middle of your “perfect build site,” you will likely have to move the house.

Lot coverage & Floor area Ratio
Understanding constraints: lot coverage and floor area ratio explained

Lot Coverage & Footprint

Zoning laws often limit how much of the specific land can be covered by impervious surfaces (buildings and pavement) to manage density and stormwater runoff.

Lot Coverage Ratio

The percentage of the total lot area covered by buildings.

  • Example: On a 5,000 sq. ft. lot with a 30% coverage limit, your total footprint (house + garage + shed) cannot exceed 1,500 sq. ft.

Floor Area Ratio (FAR)

This is a density measurement often used in urban areas. It is the ratio of total building floor area (including all stories) to the area of the land.

FAR =
Total Building Floor Area
Area of Zoning Lot

If the FAR is 0.5 on a 4,000 sq. ft. lot, the maximum square footage of the house (all floors combined) is 2,000 sq. ft.


The Permitting Process: From Application to Approval

Once you have secured the land, you enter the permitting workflow. Hands-on testing of this process reveals that utilize local government property records to access zoning maps and historical building code records for due diligence before the permitting phase begins is the most effective way to prevent surprises.

While every municipality varies, the general path is as follows:

  1. Pre-Application Meeting: Highly Recommended. Meet with local planners to discuss your small home concept. They can flag major issues (like minimum size constraints) before you spend money on detailed drawings. You will typically be meeting with urban planners or development coordinators whose careers focus on long-term city growth.
  2. Site Plan Submission: You submit a graphic representation of the proposal. This must show topography, drainage, proposed structures, parking, and setbacks. Working in collaboration with architects, engineers, and legal experts at this stage can help you build trust with city officials and ensure your submission is complete.
  3. Plan Review: The city engineers and code officials check your blueprints against local zoning ordinances and the IRC. Be prepared for a potential two-month waiting gap during this review phase depending on the city’s workload. Review cycles often range from 2 to 8 weeks, so factor this latency into your project timeline.
  4. Permit Issuance: Once approved and fees are paid, you get the “Green Light” to break ground. In many jurisdictions, this process involves receiving a specific Zoning Permit to verify land use prior to the issuance of the actual Building Permit.
  5. Inspections: You cannot build the whole house and show them at the end. You must pass mandatory checkpoints:
  • Foundation/Footings
  • Framing/Rough-in (Plumbing/Electrical)
  • Insulation
  • Final Inspection (Certificate of Occupancy)
Mandatory Inspection Checkpoints
Four mandatory checkpoints to avoid inspection failure

Failure to pass these inspections can be catastrophic. If you build without a permit or conceal work before it is inspected, the government can force you to demolish the work entirely, even if it was built perfectly, because it wasn’t authorized. Tearing down finished work is a financial disaster that typically costs 150-200% of the original build budget to rectify.

Managing Permit Submissions

For complex projects, manual tracking leads to errors. With permit management software, your team can check the status of multiple permits at a glance, track deadlines, and ensure that all documentation is submitted correctly. This reduces the risk of applications getting “lost in the pile” and helps maintain momentum.


When the Rules Don’t Fit: Variances & Special Exceptions

What happens if your small house plan violates a specific rule, like a setback or a minimum square footage requirement?

The Variance

Definition: A formal request to deviate from current zoning requirements due to a specific hardship.

The Reality: Variances are difficult to obtain. “I want a bigger yard” is not a hardship. “The lot is shaped like a triangle and I can’t fit a house within standard setbacks” is a hardship. This process requires public hearings and notifying neighbors.

Land Division and Subdivision

Can I divide and sell a piece of my property? This requires a land division approved by the City Commission, and must conform with the City’s zoning ordinances. If you plan to split a large lot to build two small homes, you must ensure both resulting lots meet the minimum area and width requirements of that zone.

Conditional Use Permits (CUP)

These are often required for non-traditional housing, such as Accessory Dwelling Units (ADUs) or “Cluster Housing” developments (multiple small homes on one lot).

Grandfathered Clauses

If you are buying a property with an existing small structure that doesn’t meet current setbacks, it may be “legal non-conforming.” You can usually maintain it, but if you tear it down, you may be forced to adhere to new, stricter rules.


Small House Specifics: Common Zoning Pitfalls

Builders of small homes (under 1,000 sq. ft.) face unique challenges that average home builders do not. Despite these hurdles, the benefits of living in a small house motivate many to navigate the extra complexity.

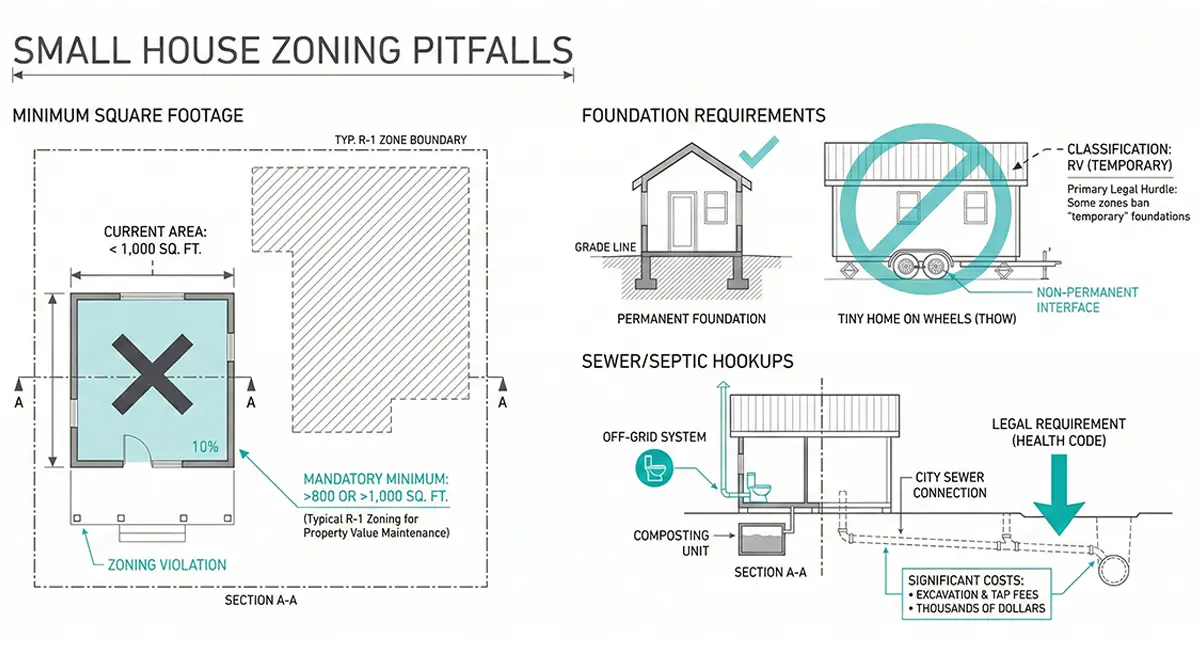

Small House Zoning Pitfalls
Zoning codes often restrict small homes through size minimums, foundation definitions, and utility hookup requirements
  • Minimum Square Footage: Many zoning districts (especially suburban R-1 zones) mandate homes be >800 or >1,000 sq. ft. to maintain property values.
  • Foundation Requirements: Some zones ban “temporary” foundations. This is the primary legal hurdle for Tiny Homes on Wheels (THOWs), which are often classified as RVs rather than permanent dwellings.
  • Sewer/Septic Hookups: Even if your small home is designed to be “off-grid” with a composting toilet, local health codes may still legally require you to connect to the sewer or install a septic system. Connecting buildings to city pipes involves significant excavation and tap fees that can cost thousands of dollars.

Quick Feasibility Checklist

Before making an offer on land for a small home, ensure you can check these off:

  • [  ] Check the Zoning District: Is it Residential? Agricultural? Does it allow single-family homes?
  • [  ] Confirm Minimum Dwelling Unit Size: Does the zone have a minimum square footage requirement that exceeds your plan?
  • [  ] Locate Survey Markers: Know exactly where your property corners are.
  • [  ] Identify Easements: Check the property title or plat map for utility or access easements.
  • [  ] Calculate Lot Coverage: Ensure your footprint fits within the coverage ratio.

Conclusion & Next Steps

Building a small home is a journey of creativity, but it must be grounded in due diligence. By understanding setbacks, FAR, and zoning designations early in the process, you protect your investment and save yourself from heartbreak during the permitting phase.
